How long can a business or school expect to wait for a new modular building to be designed, built, delivered, and installed?
New modular buildings can be designed, manufactured, delivered, and installed in as little as eight weeks—typically 30-50% faster than traditional construction. However, project complexity, planning and permitting, seasonal trends, and site preparation can impact the timeline.
Here’s an overview of a typical timeline for a new modular building project. Certain phases, such as site preparation, can coincide with design and manufacturing, significantly reducing the overall timeline and costs compared to traditional construction.
1. Design Phase (2-6 weeks)
- Conceptual Design: Modular buildings and classrooms can often be customized to meet specific needs, typically involving consultations with architects or design professionals.
- Permitting: Plans must meet local building codes and zoning requirements. Some jurisdictions may expedite modular projects due to their pre-engineered nature.
2. Manufacturing Phase (4-12 weeks)
- Modular buildings are constructed in a factory setting. This phase is significantly faster than traditional construction because the controlled environment allows concurrent activities like framing, plumbing, and electrical installation.
- Efficiency is increased since weather delays, and labor shortages are less of an issue in factory settings.
3. Site Preparation (2-8 weeks, concurrent with manufacturing)
- While the modular building sections are being built, the construction site is prepared. This includes grading, foundation work (e.g., piers or slabs), and utility connections.
- Completing site prep concurrently with manufacturing is a key time-saving advantage of modular construction.

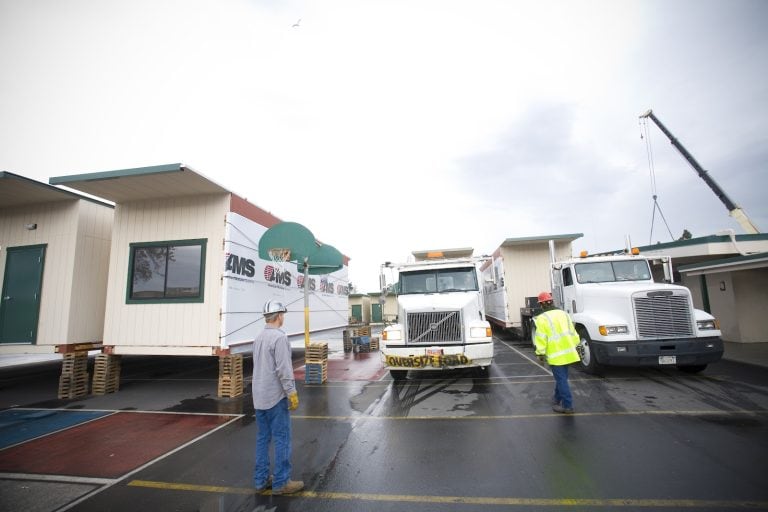

4. Delivery and Installation (1-2 weeks)
- Transportation: Modular sections are delivered to the site and staged for installation. In some cases, a crane and forklift are required.
- Installation: Modular sections are installed on an engineered foundation system. Additional work includes joining sections, sealing seams, finishing interior and exterior aspects of the space, and connecting utilities.
5. Final Touches (1-4 weeks)
- Finishing work such as interior painting, flooring, cabinetry, and inspections may be completed on-site.
- Depending on the building’s use, this may also include technology integration or landscaping.
Overall Timeline
For most modular building projects:
- Smaller buildings (e.g., portable classrooms or single-story offices): 8-16 weeks from design to completion.
- Larger, more complex buildings (e.g., multi-story or custom modular structures): 16-24 weeks or more.
Key Factors Influencing Speed
- Project Complexity: Custom designs or multi-story buildings take longer.
- Location: Permitting timelines and weather conditions can vary.
- Factory Capacity: Lead times depend on the manufacturer’s production schedule. Seasonal business trends can increase or decrease lead times.
- Site Conditions: Site prep complexity (e.g., remote locations or rugged terrain) can add time.
- Regulatory Approvals: Expedited permits can significantly reduce delays.
Modular construction is typically 30-50% faster than traditional construction methods due to its ability to overlap manufacturing and site preparation phases.
